What is a Gantt chart primarily used for in project management?
To create financial reports
To visually represent a project plan over time
To design architectural blueprints
To conduct market research

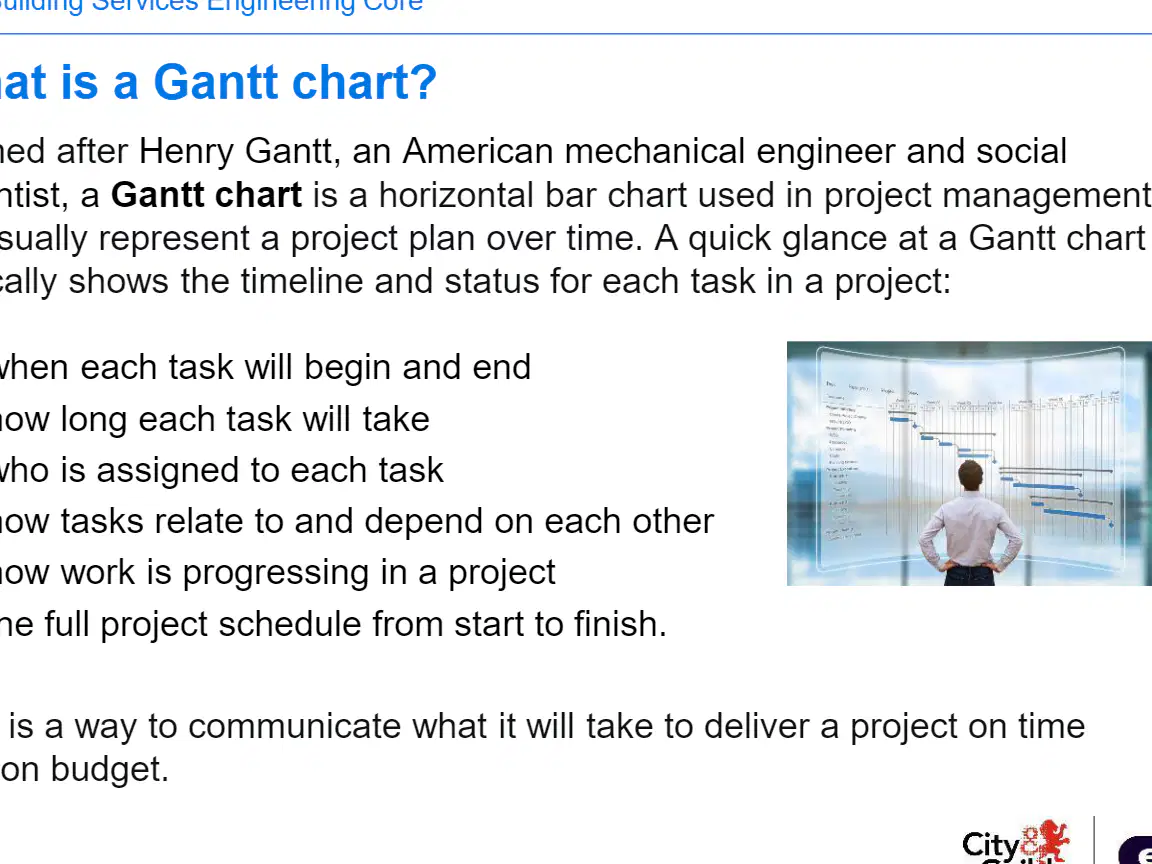

Who was the Gantt chart named after?
Henry Ford
Henry Gantt
Albert Einstein
Thomas Edison
Which of the following is NOT typically shown in a Gantt chart?
When each task will begin and end
How long each task will take
The color scheme of the project
Who is assigned to each task
What does a Gantt chart help communicate in a project?
The artistic design of the project
The budget allocation for each task
What it will take to deliver a project on time and on budget
The marketing strategy for the project
What is one of the primary uses of Gantt charts in project management?
To create financial reports
To simplify complex projects into an easy-to-follow, colour-coded plan
To design architectural models
To conduct market research
How do Gantt charts help in tracking project progress?
By providing real-time financial data
By tracking the status of tasks as work progresses
By offering customer feedback
By analyzing competitor strategies
What additional details can Gantt charts include?
Team responsible for each stage and interdependencies between stages
Weather forecasts
Stock market trends
Historical data analysis
What is the purpose of a Gantt chart in project management?
To track financial expenses
To display project timelines and task progress
To manage team communication
To evaluate employee performance

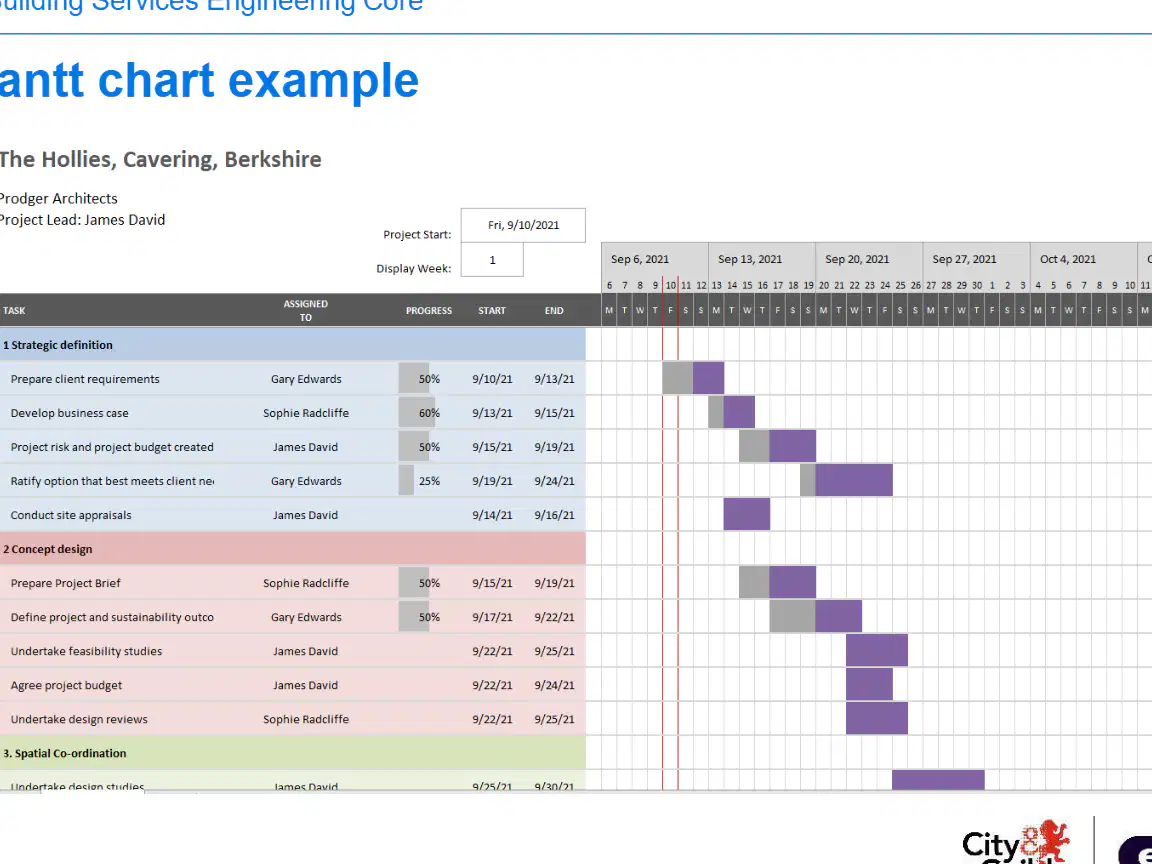

Who is responsible for preparing the client requirements in the Gantt chart example?
Sophie Radcliffe
James David
Gary Edwards
Prodger Architects
Which task is assigned to Sophie Radcliffe in the concept design phase?
Prepare client requirements
Define project and sustainability outcomes
Prepare Project Brief
Conduct site appraisals
What is the start date for the task "Develop business case"?
9/10/21
9/13/21
9/15/21
9/22/21
What does the Critical Path Method (CPM) visually represent?
The cost of each project task
The sequence of project tasks and the time required to complete each one
The resources needed for each project task
The number of people required for each project task
In the Critical Path Method, what is used to represent each task?
A color
A node (shape)
A number
A letter
What is the approach called when nodes are tied together with lines or arrows in CPM?
Activity-on-arrow (AOA)
Activity-on-node (AON)
Node-on-activity (NOA)
Arrow-on-node (AON)
What is the primary purpose of the Critical Path Method (CPM)?
To estimate project costs
To identify activities on the critical path
To allocate resources efficiently
To determine project quality

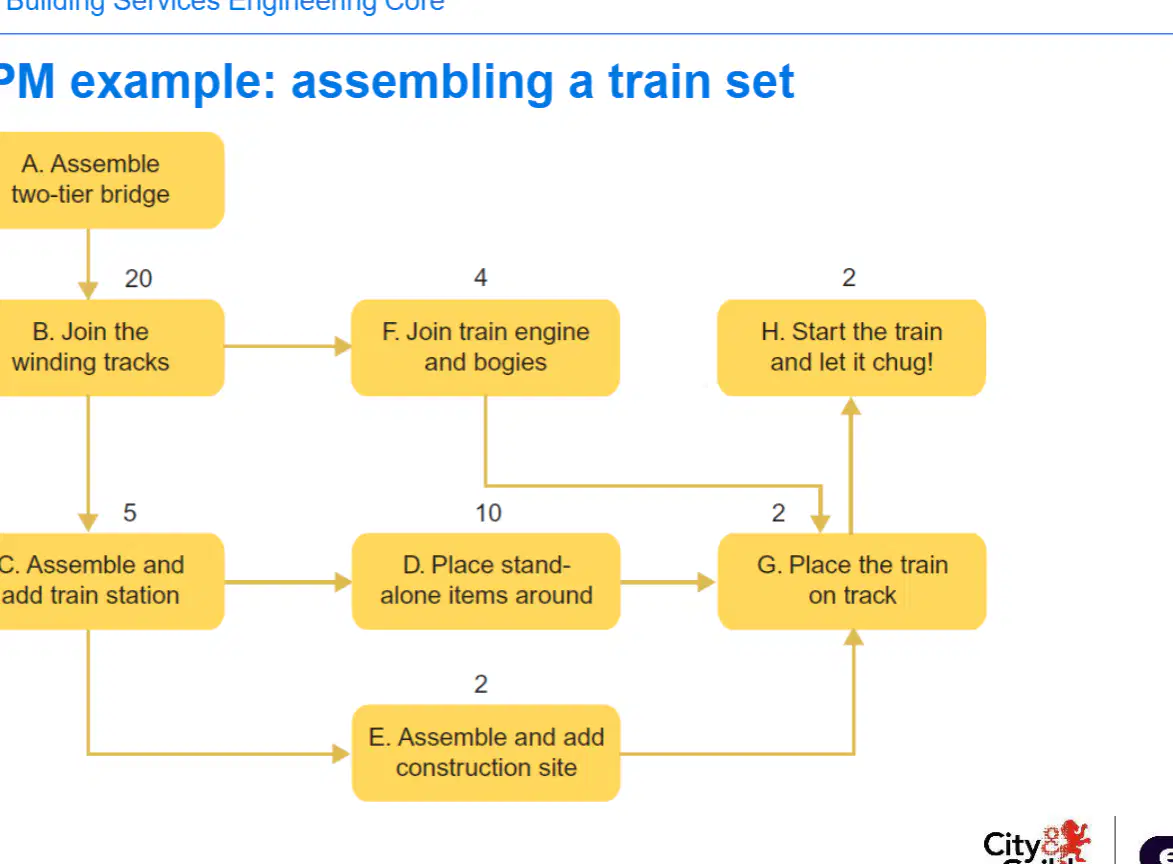

What is the first step in assembling a train set according to the CPM example?
Join the winding tracks
Assemble two-tier bridge
Place the train on track
Start the train and let it chug
Which step involves placing the train on the track?
Join train engine and bogies
Assemble and add train station
Place the train on track
Assemble two-tier bridge
How many steps are there before starting the train and letting it chug?
3
5
7
8
What is the step immediately after joining the winding tracks?
Assemble and add train station
Join train engine and bogies
Place stand-alone items around
Start the train and let it chug
What is the first step in drawing the critical path according to the document?
Establish dependencies
Specify each activity
Create a timeline
Allocate resources
Why should the list of activities in a project only include higher-level activities?
To ensure all details are covered
To make the critical path easier to manage
To include every possible task
To increase project complexity
How should you display your work breakdown according to the document?
As a paragraph
As a tree structure, lists, or tables
As a flowchart
As a mind map
What is the purpose of establishing dependencies in project activities?
To determine the budget
To identify the sequence of activities
To assign team members
To finalize the project deadline
What is the critical path analysis chart (CPA) also known as?
Dependency chart
Network diagram
Task flow chart
Activity map
What is the purpose of drawing a network diagram in project management?
To identify the shortest path
To determine task dependencies
To allocate resources
To estimate costs
What does the letter 'E' stand for in the three-point estimation method?
Estimate
Example
Equation
Event
In the three-point estimation method, what does 'a' represent?
The best-case estimate
The worst-case estimate
The average estimate
The most likely estimate
How is the estimated time 'E' calculated in the three-point estimation method?
(a + m + b)/3
(a + b)/2
(a + m + b)/2
(a + m + b)/4
What is the estimated time if the best-case estimate is 2 days, the most likely estimate is 4 days, and the worst-case estimate is 6 days?
4 days
5 days
3 days
6 days
What does the critical path in a network diagram represent?
The shortest path through the network
The path with the least number of tasks
The longest path throughout the network
The path with the most resources

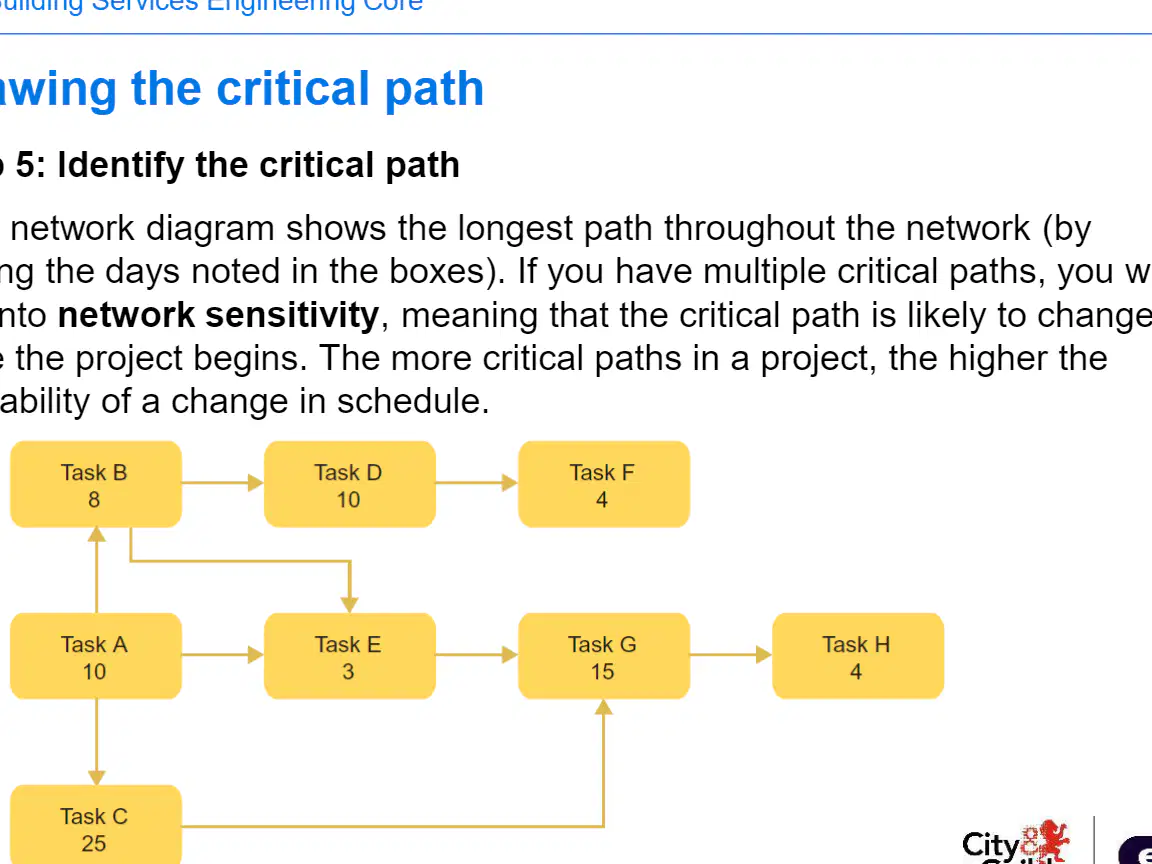

What is network sensitivity in the context of a critical path?
The ability to complete tasks faster
The likelihood of the critical path changing once the project begins
The number of resources required for a project
The shortest path in the network
What happens if there are multiple critical paths in a project?
The project will finish early
The project will require fewer resources
There is a higher probability of a change in schedule
The project will have no delays
What is one of the benefits of CPM in project management?
It increases project costs.
It identifies the most important tasks.
It complicates the project timeline.
It ignores unexpected factors.
How does CPM help in reducing risk and uncertainty?
By ignoring the shortest completion time.
By considering only the longest completion time.
By calculating the shortest and longest completion times and considering unexpected factors.
By focusing solely on financial risks.
What insight does CPM provide regarding project timelines?
It makes timelines more confusing.
It helps reduce timelines by identifying where tasks fall in the overall timeframe.
It eliminates the need for timelines.
It only focuses on the final deadline.
How does CPM compare planned with actual progress?
By ignoring the baseline schedule.
By using the baseline schedule to track schedule progress.
By focusing only on completed tasks.
By disregarding future task sequences.
What was the level of energy-related carbon emissions from the construction industry in 2019?
8.5 gigatonnes
9.95 gigatonnes
10.5 gigatonnes
7.2 gigatonnes
What percentage of total global energy-related emissions did the building construction industry account for in 2019?
25%
38%
45%
50%
By what percentage does the International Energy Agency (IEA) estimate that emissions from the building industry need to fall by 2030 to reach net zero?
25%
50%
75%
30%
What percentage of global carbon emissions is accounted for by the 4 billion tonnes of cement produced each year?
5%
8%
10%
12%
How many materials are responsible for 70% of carbon emissions?
Four
Five
Six
Seven
Why is it important to understand carbon emission data?
To increase production costs
To be fully informed and select lower carbon alternatives
To reduce the use of renewable energy
To ignore environmental impacts
